DX Integration

Financial Overview

Hybrid approach budget analysis with enhanced governance, compliance frameworks, and knowledge transfer. 48-week execution timeline with formal governance structure.

Total Project Cost
$350,000-$375,000
48-Week Hybrid Approach (Governance + Compliance)
Cost Breakdown
On-Site: $225-240k
Remote: $75-85k (21%)
Contingency: $50k (14%)
Governance & Compliance
Enhanced Framework
Steering Committee (monthly)
PMO + Working Groups (weekly/bi-weekly)
Cost Breakdown by Phase
Financial allocation across project lifecycle

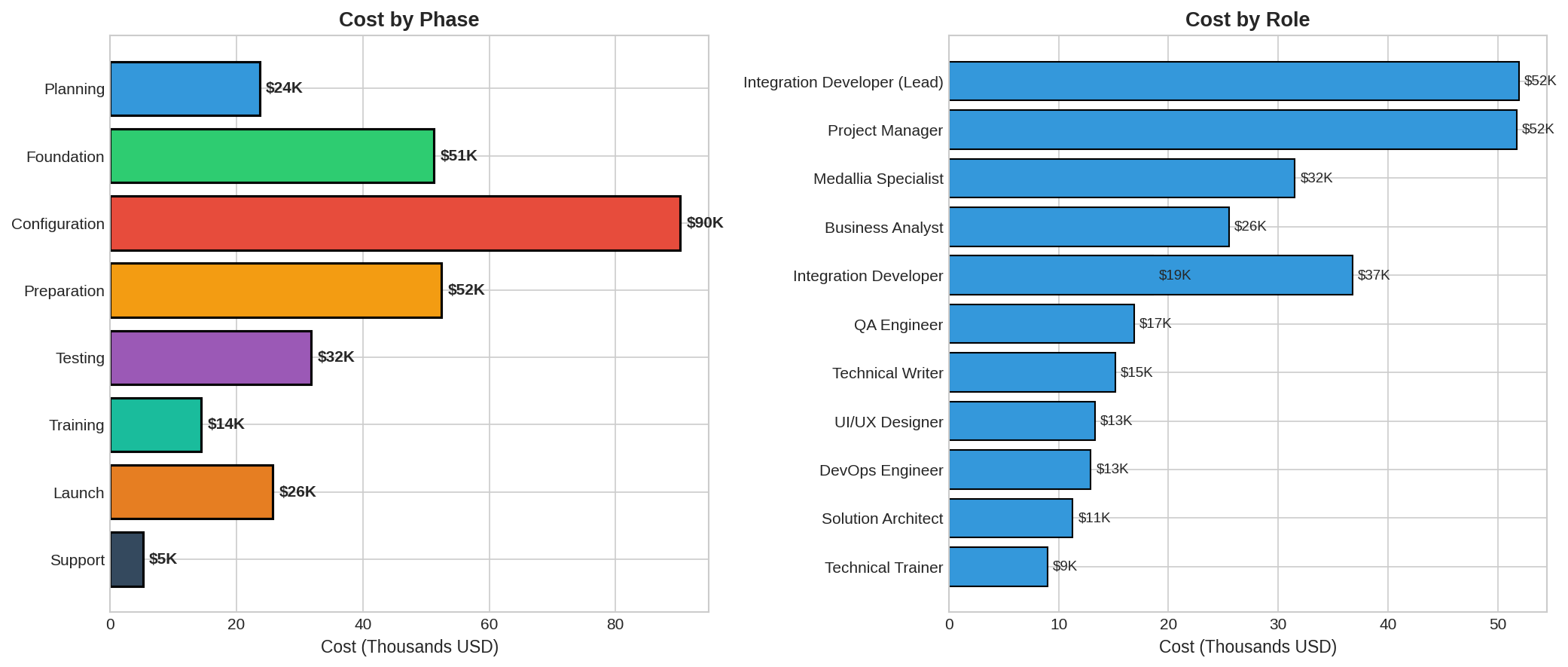

Cost Breakdown Chart
Rate Structure Analysis
Comparison of market rates vs. project rates

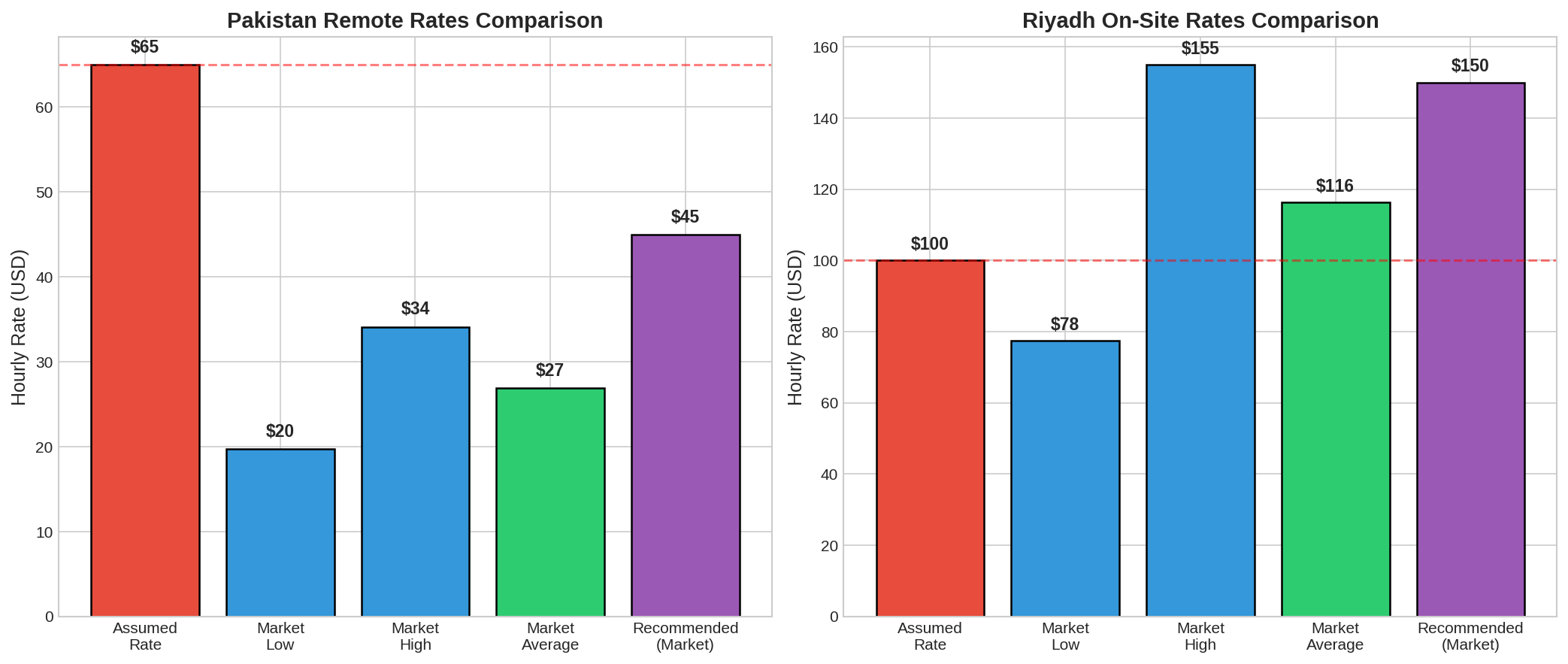

Rate Comparison Chart

Rate Strategy

The project utilizes a competitive rate structure of $75/hr for On-Site and $47/hr for Remote resources. This strategic pricing allows for high-quality delivery while maintaining budget compliance.

Total Budget
$313.9k
46-week project allocation
Baseline Cost
$273.6k
87.2% of total budget
Contingency Fund
$40.3k
0.0% used
Budget Status
On Track
No overruns detected
Contingency Fund Status
12.8% contingency buffer tracking and utilization
Total Contingency$40,263
Used$0
Remaining$40,263

Recommendation: Monitor project scope and resource utilization closely. Contingency fund is fully available for risk mitigation or scope adjustments.

Monthly Spending Projection
Planned monthly budget allocation across 46-week project
Apr 2026May 2026Jun 2026Jul 2026Aug 2026Sep 2026Oct 2026Nov 2026Dec 2026Jan 2027020000400006000080000
  • Planned Spending

Peak Spending: June 2026 ($62k) during Configuration phase. Spending tapers off in Q4 2026 and Q1 2027 during stabilization.

Cumulative Spending & Budget Burn-down
Projected cumulative cost against total budget allocation
Apr 2026May 2026Jun 2026Jul 2026Aug 2026Sep 2026Oct 2026Nov 2026Dec 2026Jan 2027080000160000240000320000
  • Cumulative Spending

Projection: Total baseline spending of $273,596 will be distributed across 10 months, with project completion by February 15, 2027.

Budget Allocation by Category
Distribution of total project budget
On-Site Work
62.8%
$196,950
Remote Work
21.2%
$66,646
Contingency
12.8%
$40,263
Cost Breakdown by Project Phase
Financial allocation across 8 delivery phases
PlanningFoundationConfigurationPreparationTestingTrainingLaunchStabilization020000400006000080000
Planning5.9%
$18,500
Foundation12.9%
$40,500
Configuration21.7%
$68,000
Preparation13.2%
$41,500
Testing13.9%
$43,500
Training3.5%
$11,000
Launch6.4%
$20,000
Stabilization22.6%
$70,859
Budget Summary
Detailed financial breakdown and projections

Total Project Budget

$313,859

Project Duration

46 Weeks

On-Site Work

$196,950

2,627 hours @ $75/hr

Remote Work

$66,646

1,418 hours @ $47/hr

Contingency (12.8%)

$40,263

Risk mitigation buffer

Payment Schedule
Milestone-based payment plan (9 payments)
MilestonePercentageAmountStatus
P1: Contract Signing10%$31,386Pending
P2: Planning Complete10%$31,386Pending
P3: Foundation Complete15%$47,079Pending
P4: Configuration Complete20%$62,772Pending
P5: Preparation Complete15%$47,079Pending
P6: Testing Complete10%$31,386Pending
P7: Training Complete5%$15,693Pending
P8: Launch Complete10%$31,386Pending
P9: Project Closure5%$19,112Pending
TOTAL100%$294,660
